Construction Update – 7/21/22
Beginning Monday, July 25 through Tuesday, July 26 there will be a road closure on Lakeshore Drive at the location shown on the map below. The road closure will allow construction crews to repair settling street pavement around a sewer manhole installed last year with the 2021 Lakeshore Drive Sanitary Sewer Improvements project. Please plan on accessing your property from 220th Street if your property is east of the pavement repair area, and from 155th Street and Lakeshore Drive if your property is west of the pavement repair area. Crews will be onsite and able to direct traffic as necessary.

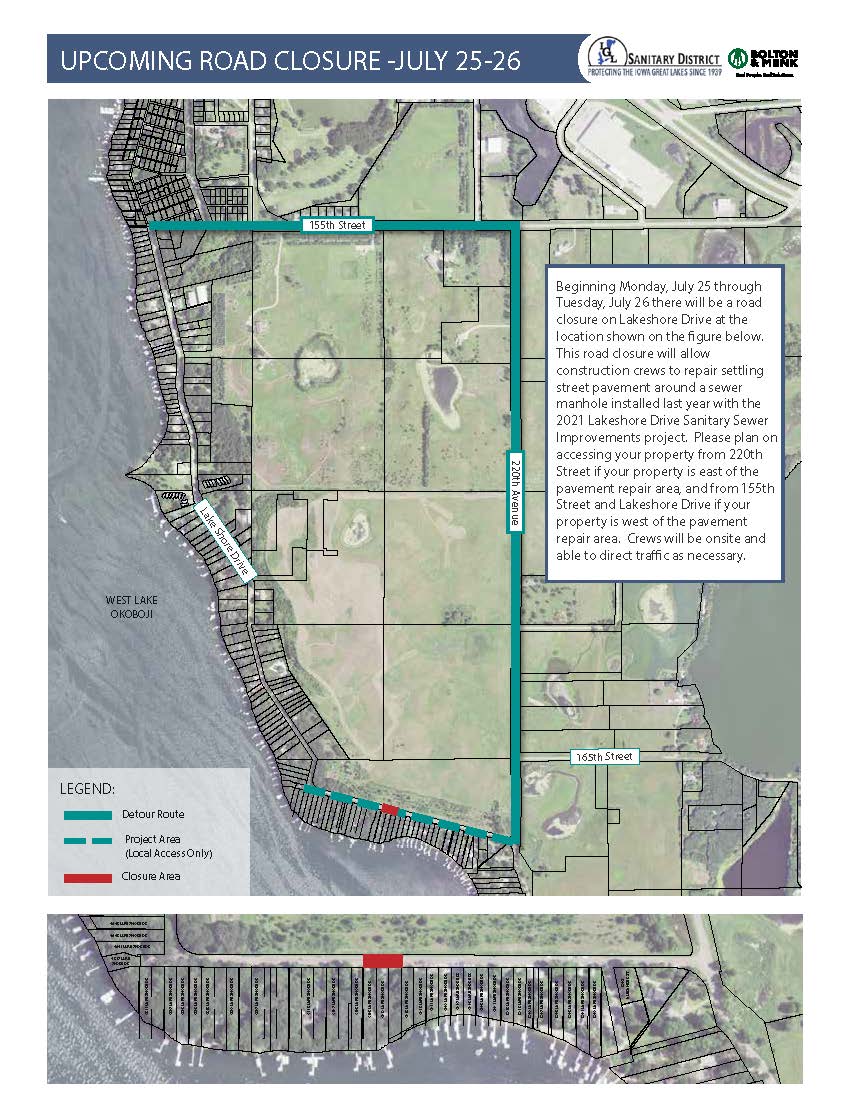

Click the image below to view a larger version of the road closure map.
Construction Update – 3/28/22
Spring 2022 (Late March)
- Detour traffic control will go into place in late March
- Remaining excavation work on the east end of the project corridor will occur
- Excavation pits will be cleaned up and prepared for paving and curb replacement in early April
- Concrete curb and gutters and final pavement will be installed in mid April
- Final sodding and seeding to occur in late April
- Site cleanup and punch list work is anticipated to occur in late April and early May
Additional Information and Feedback
- An access lane will be provided through the site at all times. Please be on the lookout for barrels and other traffic control items as you access the site. Through traffic should utilize the posted detour.
- In general, mail and garbage service are anticipated not to be impacted during construction. If drop-off/pick-up locations need to be adjusted during construction project staff will coordinate with you.
For future project updates, go to the project website (IGLSD-ProtectingOurBlueWater.com) and sign up for email updates.
Construction Update – 12/9/21
Month of December 2021
- Construction crews will continue utility excavation pits moving from west to east along the corridor
- Traffic access will remain restricted to one lane for local traffic only
- Sanitary sewer work will continue with casing pipe installation moving from west to east
- Sanitary sewer installation will continue from west to east.
- Temporary gravel surfacing in excavated roadway areas will begin to be installed
- The area will be seeded with temporary seed over winter suspension
- Detour signage will be taken down in late December
Spring 2022
- Temporary gravel surfacing in excavated roadway areas will be removed and permanent asphalt pavement will be installed
- Any impacted driveways or other facilities will be permanently restored
- Permanent seeding work will be completed
Additional Information and Feedback
- An access lane will be provided through the site at all times. Please be on the lookout for barrels and other traffic control items as you access the site. Through traffic should utilize the posted detour.
- Mail and garbage service has been maintained throughout construction. The contractor will contact you and coordinate any adjustments that may be necessary if services need to be impacted.
For future project updates, go to the project website (IGLSD-ProtectingOurBlueWater.com) and sign up for email updates.
Construction Update – 10/27
This Week (Week of October 25)
- Construction crews will continue utility excavation pits moving from west to east along the corridor
- Traffic access will remain restricted to one lane for local traffic only
- Sanitary sewer work will continue with casing pipe installation moving from west to east
- Sanitary sewer installation will continue from west to east.
Week of November 1
- Utility excavation pit excavation work will continue from west to east along the corridor
- Sanitary sewer casing and sewer construction will continue
- Expect to see continued work on the West end of the project as services, existing mains, and manholes are connected.
Additional Information and Feedback
- An access lane will be provided through the site at all times. Please be on the lookout for barrels and other traffic control items as you access the site. Through traffic should utilize the posted detour.
- Mail and garbage service has been maintained throughout construction. The contractor will contact you and coordinate any adjustments that may be necessary if services need to be impacted.
For future project updates, go to the project website (IGLSD-ProtectingOurBlueWater.com) and sign up for email updates.
Construction Update – 10/12
Next Week (Week of October 18)
- Construction crews will continue utility excavation pits moving from west to east along the corridor
- Traffic access will remain restricted to one lane for local traffic only
- Sanitary sewer boring construction will begin
Week of October 25
- Utility excavation pit excavation work will continue from west to east along the corridor
- Sanitary sewer boring construction will continue
Additional Information and Feedback
- An access lane will be provided through the site at all times. Please be on the lookout for barrels and other traffic control items as you access the site. Through traffic should utilize the posted detour.
- Mail and garbage service has been maintained throughout construction. The contractor will contact you and coordinate any adjustments that may be necessary if services need to be impacted.
For future project updates, go to the project website (IGLSD-ProtectingOurBlueWater.com) and sign up for email updates.
Construction Update – 9/17/2021
Next Week (Week of September 20)
- Advanced notice detour signage will be installed.
Week of September 27
- The project detour will go into effect on Monday, September 27.
- Construction equipment will begin to be mobilized to the site.
- Erosion control and temporary fencing work will begin
- Excavation for utility location verification will begin
- Boring pit excavation is expected to begin on the west end of the project (near Colcord Point) late this week.
Additional Information and Feedback
- An access lane will be provided through the site at all times. Please be on the lookout for barrels and other traffic control items as you access the site. Through traffic should utilize the posted detour.
- In general, mail and garbage service are anticipated not to be impacted during construction. If drop-off/pick-up locations need to be adjusted during construction project staff will coordinate with you.
- For future project updates, go to the project website (IGLSD-ProtectingOurBlueWater.com) and sign up for email updates.
