Project Updates
Week of August 6, 2018
- Grading and roadway crews continue to work on Waconia Parkway from Pond Lane to CSAH 32.
- Crews are also working on the pedestrian underpass and bridge on Waconia Parkway.
- Utility crews are currently working on storm sewer installation between Community Drive and Waconia Parkway.
- Grading crews are working on surcharge embankment removal in preparation of roadway construction from Community Drive to Waconia Parkway.
Please review the Traffic Impacts/Detours Page for upcoming road closure information!
Week of June 14, 2018
- Grading and roadway crews are working on Waconia Parkway from Pond Lane to CSAH 32.
- Draintile relocations are in progress along the closed portion of Waconia Parkway.

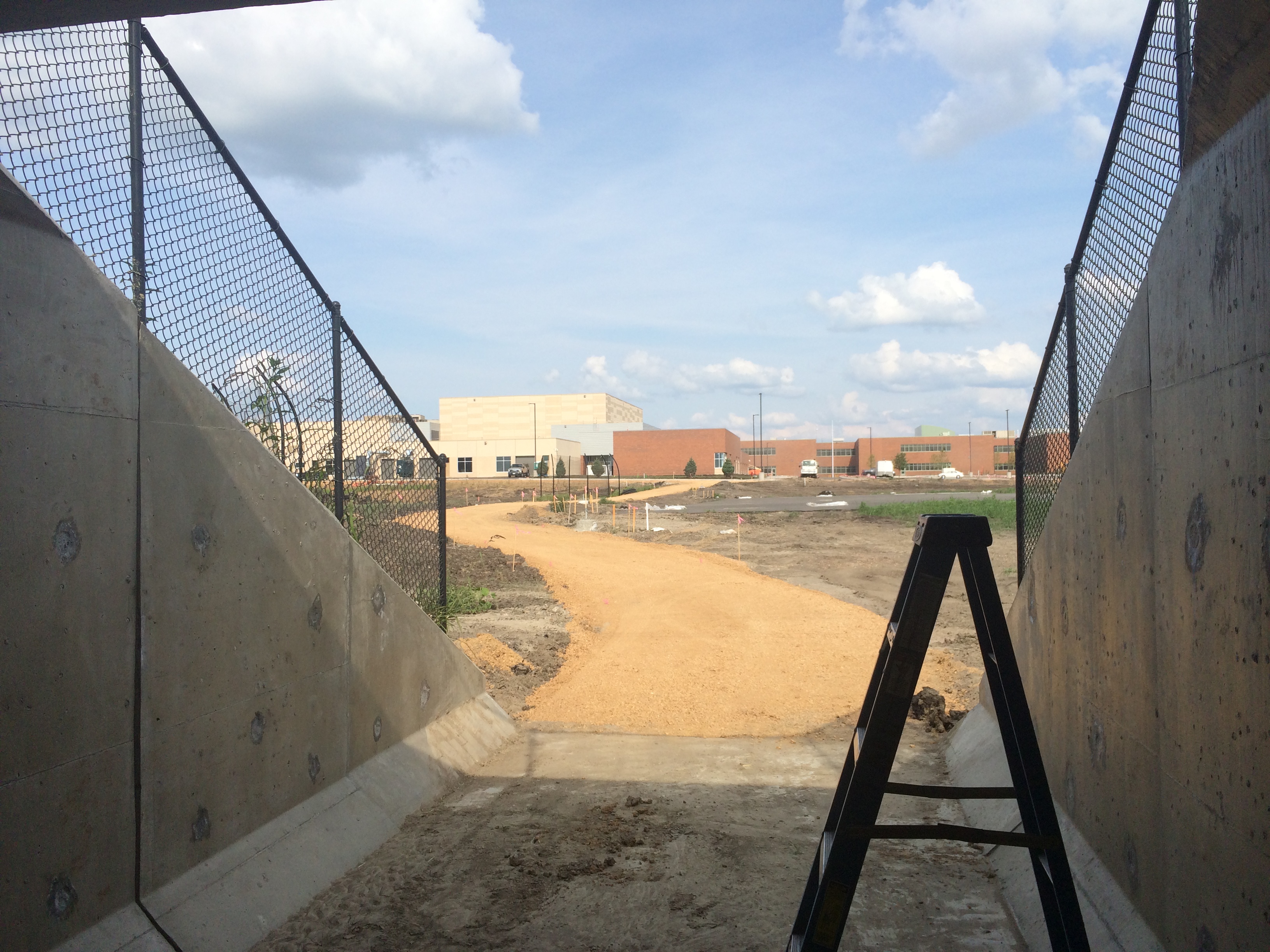

- Utility crews are preparing to install the pedestrian underpass at the proposed CSAH 10 and Waconia Parkway intersection.
Please review the Traffic Impacts/Detours Page for upcoming road closure information!
Week of May 14, 2018
- Grading crews are working on the trail between Community Drive and Highway 5.
- Grading Crews are also working on installing surcharge material between Community Drive and Waconia Parkway.
- Private utility crews are working on utility relocations along Waconia Parkway between Pond Lane and Sterling Road.
Please review the Traffic Impacts/Detours Page for upcoming road closure information!
November 3, 2017
Week of November 6
- Signs will be installed
- After this week, work will be suspended over winter and resume next spring.
October 12, 2017
Week of October 9
- Site grading continued
Week of October 16
- Site grading will continue
Week of October 2
- Site grading continued
- The Community Drive roundabout concrete sealing finished
Week of October 9
- Trail base construction resume
Week of September 25
- Site grading
Week of October 2
- Site grading will continue
- Trail base construction will continue
Week of September 18
- Class 5 surfacing was installed on Orchard south of Highway 5 and that segment of road is now open to traffic.
- Crews conducted final grading behind the curb lines starting near Highway 5 and moving north.
- Trail base construction began
Week of September 25
- Concrete crews will be installing the maintenance strip inside the medians and working on permanent sign base installation.
- Trail base construction will continue
September 15, 2017
Week of September 11
- Phase 1 is now open to traffic!
- Roadway crews placed the aggregate base on Orchard south of Highway 5.
- Crews installed signs between Highway 5 and Community Drive
- Paving has been completed
- Temporary striping was painted
- Material placement on the north surcharge area will be complete this week.
Week of September 18
- Crews will begin final grading behind the curb lines starting near Highway 5 and moving north.
- Concrete crews will be installing the maintenance strip inside the medians and working on permanent sign base installation.
- Trail base construction may begin at the end of the week.
September 8, 2017
Week of September 5
- Concrete work completed this week
- Aggregate base tolerance work will begin tomorrow and be complete by Saturday
- Bituminous paving is scheduled to start on Saturday and be complete on Wednesday
Week of September 11
- Paving crews will complete roadway paving by Wednesday.
- Striping crews will be on site on Wednesday or Thursday
- Sign installation crews will be on site on Wednesday or Thursday
September 1, 2017
Week of August 28
- Concrete crews are working on mainline curb, which will be complete by the end of the week.
- Concrete crews will be in on Friday to complete remaining curb, median noses and truck apron.
- Grading crews are working on trial and backslope grading.
- Sand is being hauled in and placed on both surcharge areas.
Week of September 5
No work will take place on Monday, September 4.
- Concrete crews will complete catchbasin and other miscellaneous concrete work.
- Road crews will work on tolerance the aggregate roadway base.
- Sand and clay borrow will continue to be placed on the surcharge areas
- Grading and topsoil placement will continue from Highway 5 to Community Drive.
Week of August 21
- Completing sand installation at the Community Dr roundabout
- Aggregate base installation will continue from Highway 5 and moving north to Community Dr.
- Hauling and placement of stage 2 surcharge material will began late this week
- Touching up grading on Highway 5 at the end of the week.
- Permanent seeding on Highway 5 on Friday
Week of August 28
- Curb and gutter crew is scheduled to begin work on Monday and continue through the week
- Stage 2 surcharge operation will continue
Traffic Notes:
Trucks will again be hauling aggregate material to the site using County Road 10 / Waconia Parkway to access the construction entrance at the north end of the project. Please use caution and be aware of turning trucks on County Road 10 / Waconia Parkway between Pond Lane and County Road 32.
Highway 5 at Orchard Road is now open.
Week of August 7
- Road crews began installing material between 94th Street and Community Drive.
- Grading crews began working on subgrade preparation near Community Drive and grading shoulders and back slopes north of Highway 5.
- Sand has been installed up to the Community Drive roundabout
Week of August 14
- Concrete crews will install curb and gutter from Highway 5 to 94th Street
- Concrete crews will install median and pedestrian ramps from Highway 5 to 94th
- Road crews will continue to install aggregate base from 94th Street to Community Drive.
- Paving crews will begin paving late in the week
August 4, 2017
Highway 5 is closed at Orchard Rd. Please see the map below for detour information:
Week of July 31

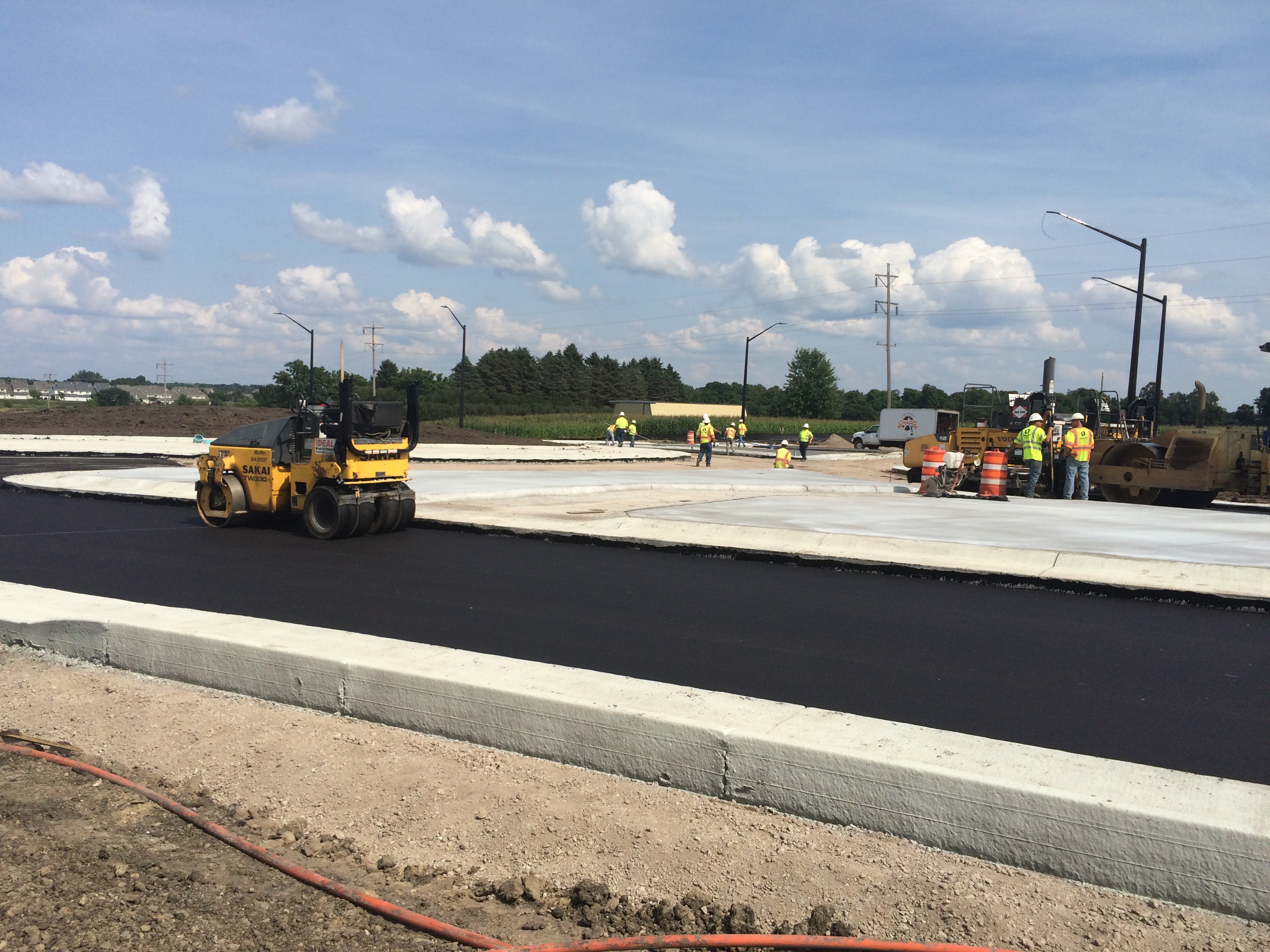

- Roadway crews are installing aggregate base. Paving will continue through Saturday
- Crews installing concrete curb and gutter and medians at the TH 5 intersection
- Roadway crews began installing sand sub-base on CSAH 10 north of TH 5
Week of August 7
- Concrete joint sealing will begin on Monday
- Striping crews are scheduled to complete work on TH 5 Wednesday
- Sign installation will be completed on Monday and Tuesday
- Crews will continue with subgrade and sand up to Community Drive
- Bike trail work will begin south of TH 5
- Boulevard and median topsoil and seeding will be completed early in the week
July 21, 2017
Highway 5 is closed at Orchard Rd. Please see the map below for detour information:
Week of July 24
- Roadway aggregate base placement occurred
- Curb was installed within the Highway 5 roundabout
- Mainline curb is scheduled to be complete by Saturday, and concrete crews will move into median and truck apron paving
Week of July 31
- Utility crews will have all utilities installed up to Community Drive by the end of the week
- Roadway crews will install the final lift of aggregate base
- Concrete crews will complete driveway and pedestrian ramp construction early in the week.
- Paving crews are scheduled to begin paving at the end of the week.
- Roadway lights and signs will be installed
