Business Highway 71

Proposed Improvements
The City of Willmar is planning to improve the Business Highway 71 Area.
Improvements include:
- Pavement resurfacing
- Concrete curb and gutter/median spot repair
- Traffic sign replacements
- Traffic signal improvements
- Pedestrian crossing improvements
- Path improvements
The City of Willmar is undertaking a pavement resurfacing project on Business Highway 71 from 10th Street NE/Robbins Island entrance to 26th Avenue NE/CSAH 24. The scope of the work includes the removal and replacement of the top layer of asphalt pavement, spot concrete repairs, and improvements to the traffic signal at Civic Center Drive. Additionally, the project will feature pedestrian crossing enhancements at the 10th Street NE/Robbins Island entrance and path improvements along the corridor near Civic Center Drive.

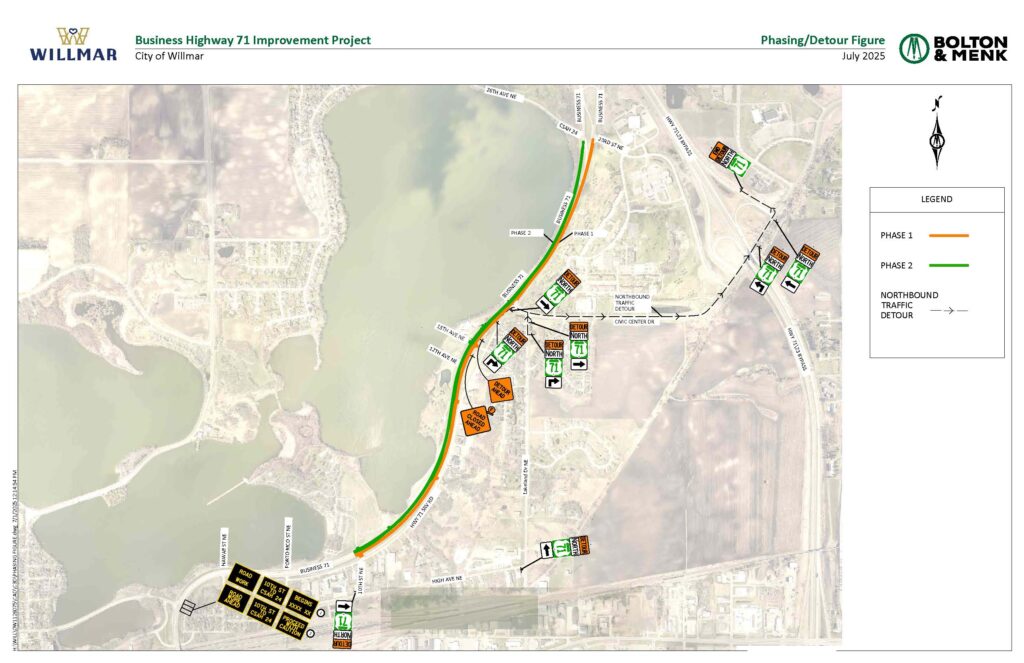

Construction will occur in two phases on this four-lane divided highway. Each phase will involve the closure of one half of the roadway, while the remaining lanes will accommodate two-way traffic. A detour will be in place to redirect northbound traffic to the Highway 71/23 Bypass via Civic Center Drive. Access to Robbins Island, the Flags of Honor Memorial, and Bright Lights UCAP Head Start will be maintained throughout the project, with only minor closures anticipated.
Although Business Highway 71 will remain open during construction, traffic delays are expected. Motorists are encouraged to consider alternate routes when possible. Phase 1, which includes work on the northbound lanes (east half), is scheduled to begin on July 8 and conclude by mid-August 2025. Phase 2, involving the southbound lanes (west half), is expected to commence in mid-August and be completed by late September 2025. The entire project is anticipated to be finalized by early October 2025.
Project updates will be posted on the website and electronically distributed to subscribers as work progresses. Please feel free to reach out to any of the contacts provided if you have any questions.
Project Updates
August 25, 2025
Anticipated Construction Schedule:
Phase 1 – Northbound Lanes (East Half of Highway)
Phase 1 is substantially complete and is being utilized to maintain two-way traffic on Business Highway 71 during the construction of Phase 2.
Phase 2 – Southbound Lanes (West Half of Highway)
Week of August 25, 2025
- Concrete spot replacement
- Asphalt pavement patching
- Rehabilitation of existing path along Business 71 from Bright Lights UCAP Head Start to Civic Center Drive (August 28th)
- Civic Center Drive traffic signal work (continued)
Week of September 2, 2025
- No work is scheduled for Labor Day (September 1)
- Install asphalt underseal (September 2)
- Install asphalt pavement on new path connection south of Bright Lights UCAP Head Start (September 4)
- Install asphalt pavement on Business 71 (September 4 and 5)
Week of September 8, 2025
- Catch basin casting rehabilitation
Week of September 15, 2025
- Install concrete pedestrian ramps
Phase 1 & Phase 2
Week of September 22, 2025
- Turf restoration
- Installation of permanent pavement markings
- Installation of permanent signage
Week of September 29, 2025
- Installation of permanent signage (continued)
- Removal of temporary traffic control and open all lanes to traffic
We appreciate your patience and understanding as we work to improve your streets.
Contractor
Minnesota Paving and Materials
Rogers, MN
Documents
Project documents coming soon!
Engineer Contacts
Christopher Holm
Onsite Construction Representative
(320) 737-0534
chris.holm@bolton-menk.com
Spencer Johnson
Project Manager, Bolton & Menk, Inc.
(320)-979-6136
Spencer.Johnson@bolton-menk.com
Contractor Contact
Scott Bednar
Minnesota Paving and Materials
(320)-470-8112
scott.bednar@minnpm.com
