Spring Valley 2026 Active Transportation Improvements
The Spring Valley 2026 Active Transportation Improvements project is a community-initiated effort to enhance pedestrian infrastructure in the heart of Spring Valley. It was made possible through support from Spring Valley City Council, a partnership with Fillmore County, and funding from the MnDOT Active Transportation Grant Program.
Grant: MnDOT Agreement No. 1062855 / SAP No. 023-601-037, State Active Transportation (AT) Program, 2026 Active Transportation Improvements
Agency Leadership: Deb Zimmer, City Clerk-Treasurer, 507-346-7367
Grant Manager: Drew Weber, City Engineer, 507-469-0306, [email protected]
Contractor: A-1 Excavating, LLC of Bloomer, WI
What’s Happening?
The project will upgrade sidewalks along Broadway Avenue and improve crossings at Main Street, Courtland Street, and Jefferson Street—making it safer and easier for residents to access local businesses and amenities. A sidewalk will also be added along Main Street to connect Section Avenue to Willow Park, filling a gap in the city trail system.
Construction Update
Construction Progress Update – Week of July 13
- The contractor installed signs and striping for Phase 1 area.
- The contractor completed Phase 2 removals (besides sidewalk at the Main St intersection)
- The contractor installed sidewalk along Main St between Section Ave and Willow Park
- The contractor installed curb and gutter and pavement at the southeast corner of Courtland St & Broadway Ave
Planned Construction Schedule – Week of July 20
- The contractor plans to install sidewalk at the SE corner of Courtland St and Broadway Ave
- The contractor plans to begin utility installation at the Main St intersection
General Project Information:
- The north block is now open to through traffic. Please exit west at Courtland Ave.
- Broadway Ave will remain open to pedestrian access on temporary walkways throughout the project duration, take care when walking throughout downtown and near construction equipment.
- The Community Center will remain open through construction at Main St with an alternate access to the building’s back door ramp.
- As construction continues, the temporary pedestrian access routes will vary. If you need help or would like advice on the best route through the construction zone, please contact David at 507-701-7611
Contact Us
If you have questions or concerns, please contact David Anderle at 507-701-7611 or Drew Weber at 507-469-0306.

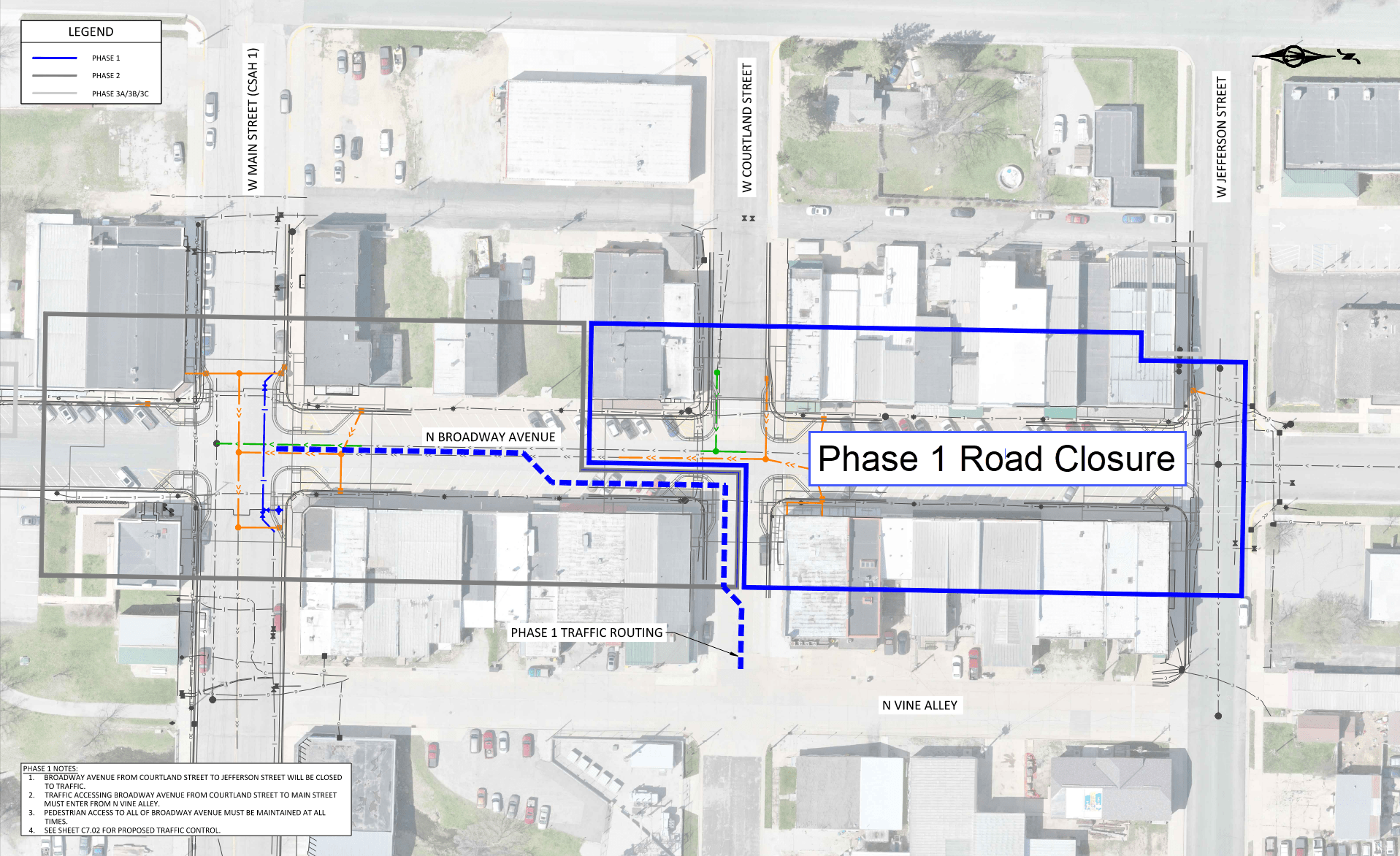

Construction Phasing
- In general, work will begin with curb and street removals, and utility installation will follow removals. The contractor will then install new curbs and sidewalks, followed by paving the new road surface.
- Once Phase 1 is substantially completed, the contractor will begin Phase 2. Additional information will be posted as work progresses.
