Overview

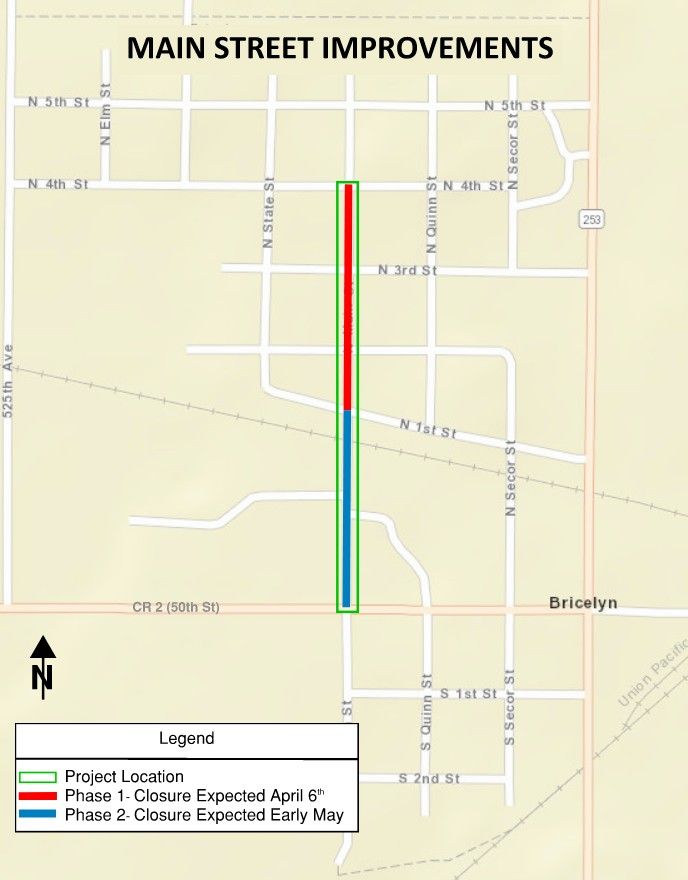

Main Street construction project will includer a full reconstruction of the existing street from 50th Street to North 4th Street. The existing street will be removed and replaced with concrete and asphalt pavement. New watermain, sanitary sewer, and storm sewer will be installed as part of the project. Some existing sidewalks will remain in place for a duration of time to maintain access to businesses on Main Street. A detour will be set up for through traffic to use N State Street and N 5th Street. The construction will begin the week of April 6th with a substantial completion date of July 1, 2026.

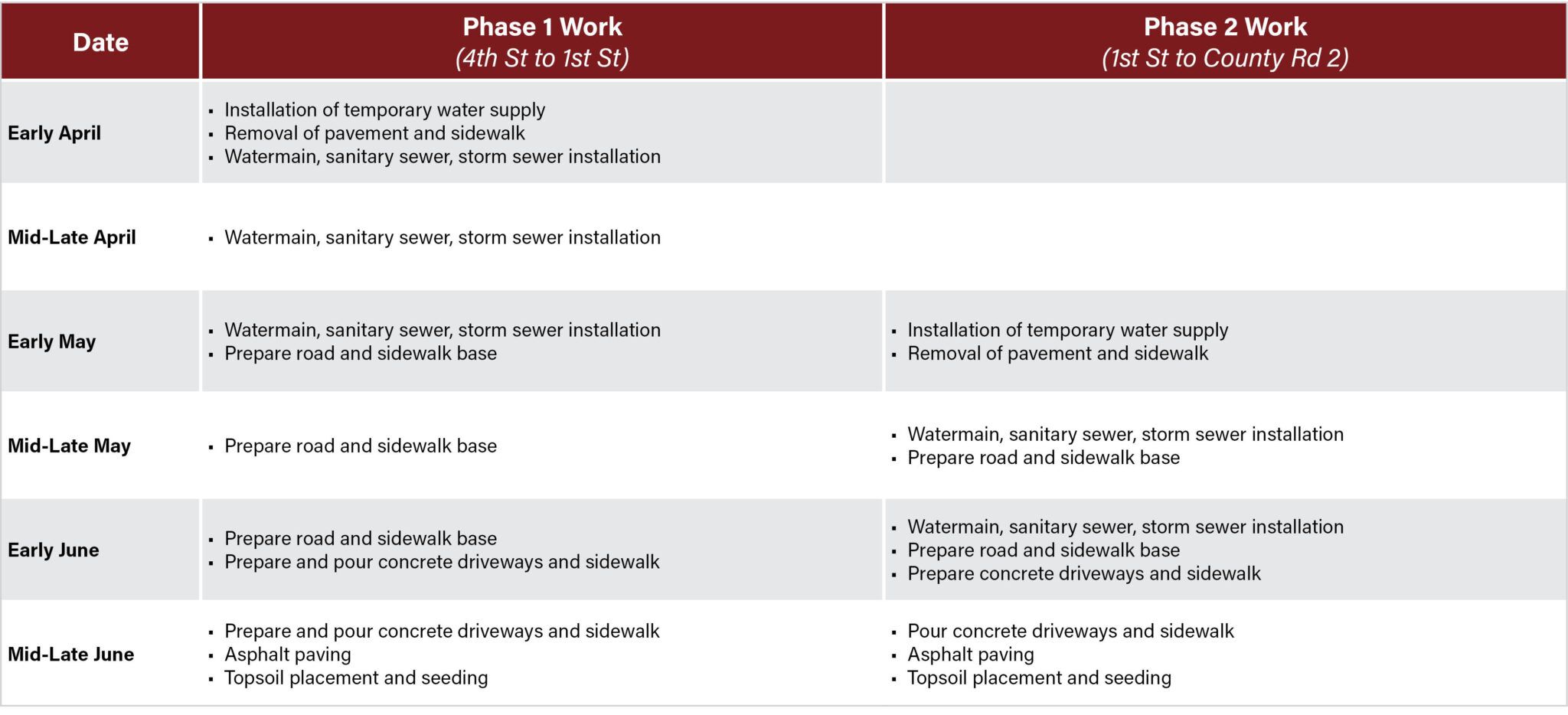

Approximate Schedule of Construction
*NOTE: THE SCHEDULE IS WEATHER-DEPENDENT, RAIN COULD CAUSE DELAYS. THIS SCHEDULE SHOULD BE TREATED AS A GUIDELINE RATHER THAN A FIRM PLAN.
Project Contacts
Project Engineer
Troy Nemmers, PE
(507) 236-9832
Resident Project Representative
Emma Sullivan
(507) 810-9158
City of Bricelyn
Kathleen Lowery, City Cleark/Treasurer
(507) 653-4367
City of Bricelyn
Dave Albrant, Public Works Director
(507) 402-0010
Contractor
Holtmeier Construction
Matt Schneider
(507) 995-9187
