Construction Updates
2026 Updates
May 29, 2026
All sanitary sewer and watermain installations, including individual sanitary and water services, have been completed. Storm sewer construction is nearing completion, with only a few remaining catch basins left to install.
Aggregate base has been placed on Main Street, south of the railroad tracks. The concrete crew is scheduled to arrive on Monday, June 1, to prepare the roadway for paving, with the goal of concrete paving by the end of the week.
While the concrete crew works south of the railroad tracks, Holtmeier will continue preparing Main Street north of the tracks for aggregate base installation. During this phase, please expect uneven or rough surfaces. However, the gravel sidewalk providing access to local businesses will remain open.
April 24, 2026
Holtmeier has been making good progress on the underground infrastructure the first few weeks of construction on Main Street. Watermain and Sanitary sewer mainline work is estimated to continue for the next couple of weeks with installation of services following.

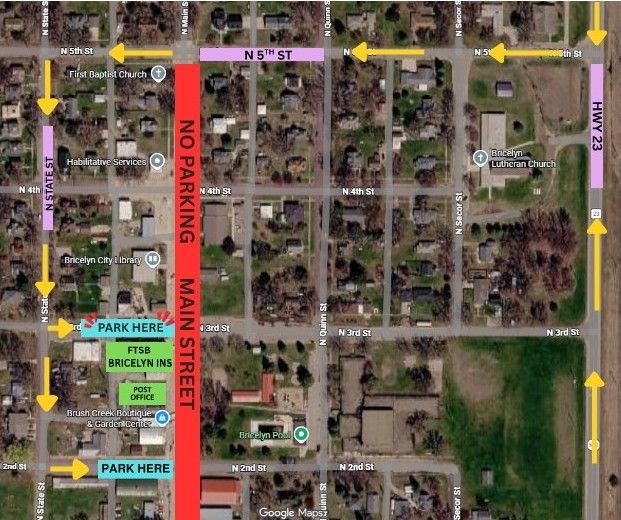

BUSINESS ACCESS: To access the businesses on Main Street, drive west on 5th Street and south on State Street. There is parking available on 2nd Street, 3rd Street, 4th Street, and behind the businesses in the alley. There is still sidewalk access to all businesses. For safety we ask everyone to refrain from walking across Main Street through the project.
April 13, 2026
The City of Bricelyn will conduct a city‑wide water shutdown on Tuesday, April 14, from 8:00 AM to 4:00 PM, weather permitting. If weather conditions prevent the shutdown from occurring as scheduled, it will be rescheduled for Wednesday, April 15, during the same hours. The city will do its best to notify residents when water is back on. Please flush your water lines for 1-2 minutes prior to use immediately following the shutdown.
