Street Improvement Project – West
Eagle Ridge Drive W Area, 7TH Avenue NW Area, & 21ST Avenue SW Area
Proposed Improvements
The City of Willmar is planning to improve the Eagle Ridge Drive W Area, 7TH Avenue NW Area, & 21ST Avenue SW Area.
Improvements include:
- Asphalt surfacing
- Concrete curb and gutter spot repair
A construction newsletter has been distributed to all residents within the project area. This newsletter outlines the general sequence of construction and provides estimated timeframes for each phase. Moving forward, all project updates will be posted on the project website and distributed electronically to subscribers via email and text message.
If you have any questions or concerns that are not addressed in the newsletter or with this update, please do not hesitate to reach out to the project contacts listed on the website.
Construction Updates
May 8, 2026
The Contractor’s anticipated schedule for the next three weeks is provided below. As always, this schedule is subject to change based on weather conditions.

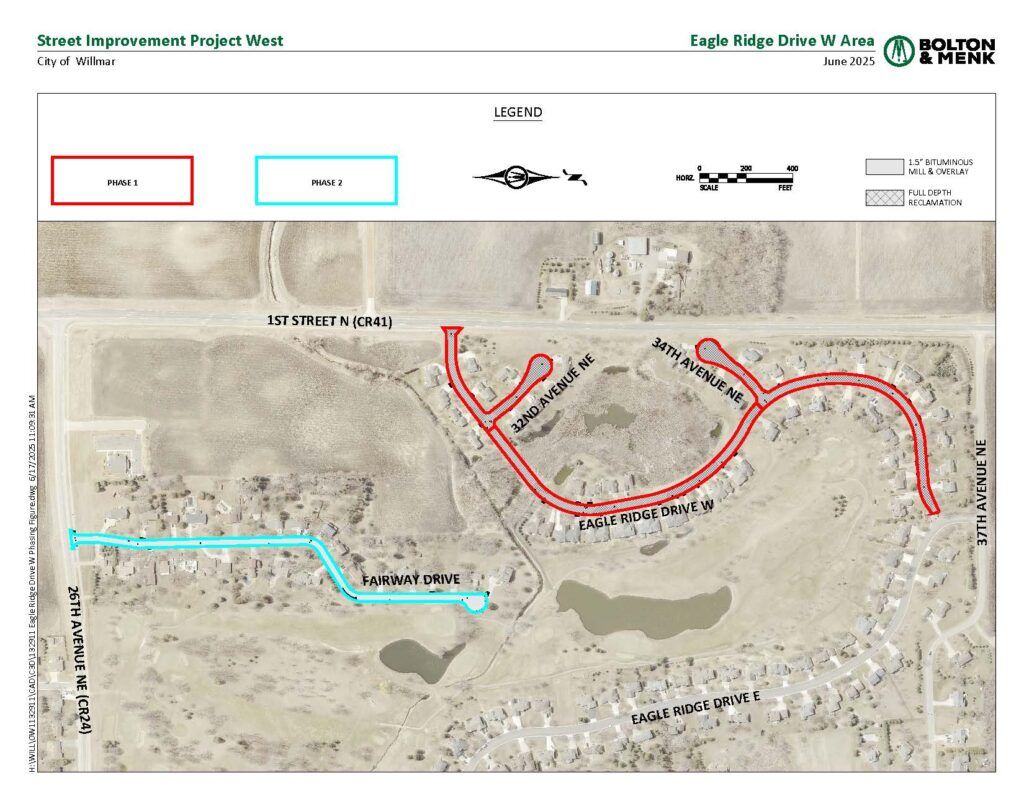

Phase 1 – Eagle Ridge Drive West Area (Full Depth Reclamation)
Week of May 11
- Concrete warranty
- Seeding warranty
- Punchlist items
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items
Phase 2 – Fairway Drive NE (Mill & Overlay)
Week of May 11
- Concrete warranty
- Seeding warranty
- Punchlist items
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items
Phase 3 – 29th Street NW (Full Depth Reclamation)
Week of May 11
- Concrete warranty (7 day cure time)
- Bituminous Patching (May 13)
- Paving final lift of bituminous pavement (May 14 or 15)
- Seeding warranty
- Punchlist Items
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items

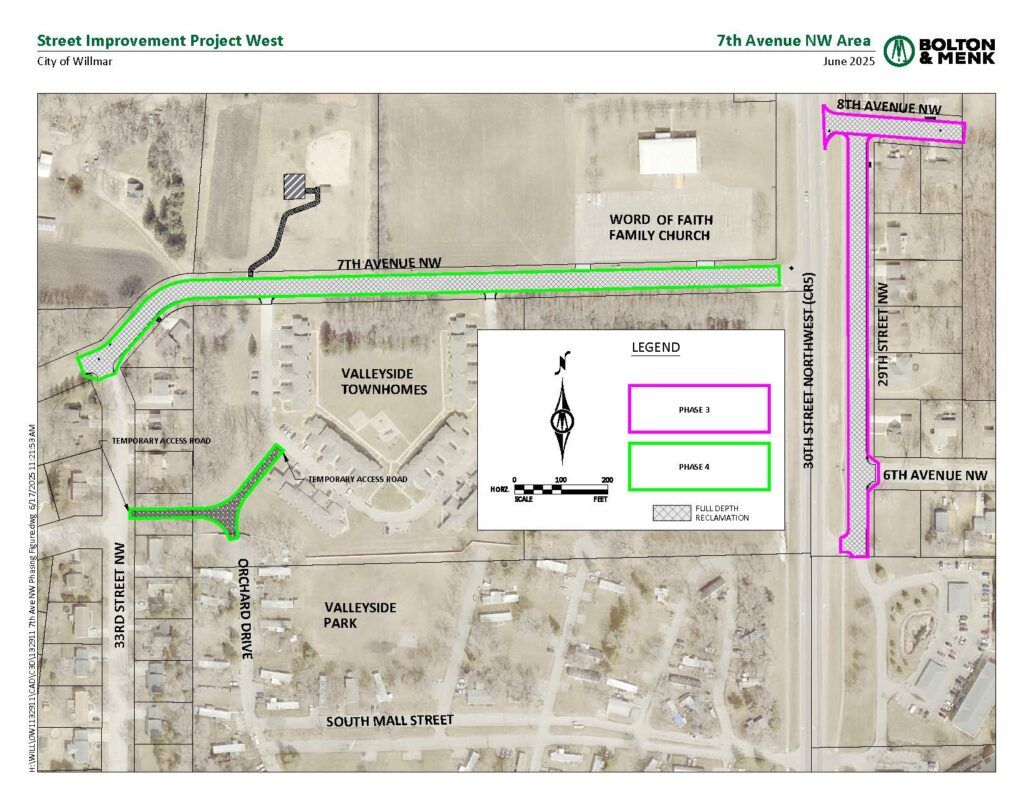

Phase 4 – 7th Avenue NW (Full Depth Reclamation)
Week of May 11
- Concrete warranty (7 day cure time)
- Seeding warranty
- Punchlist
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items

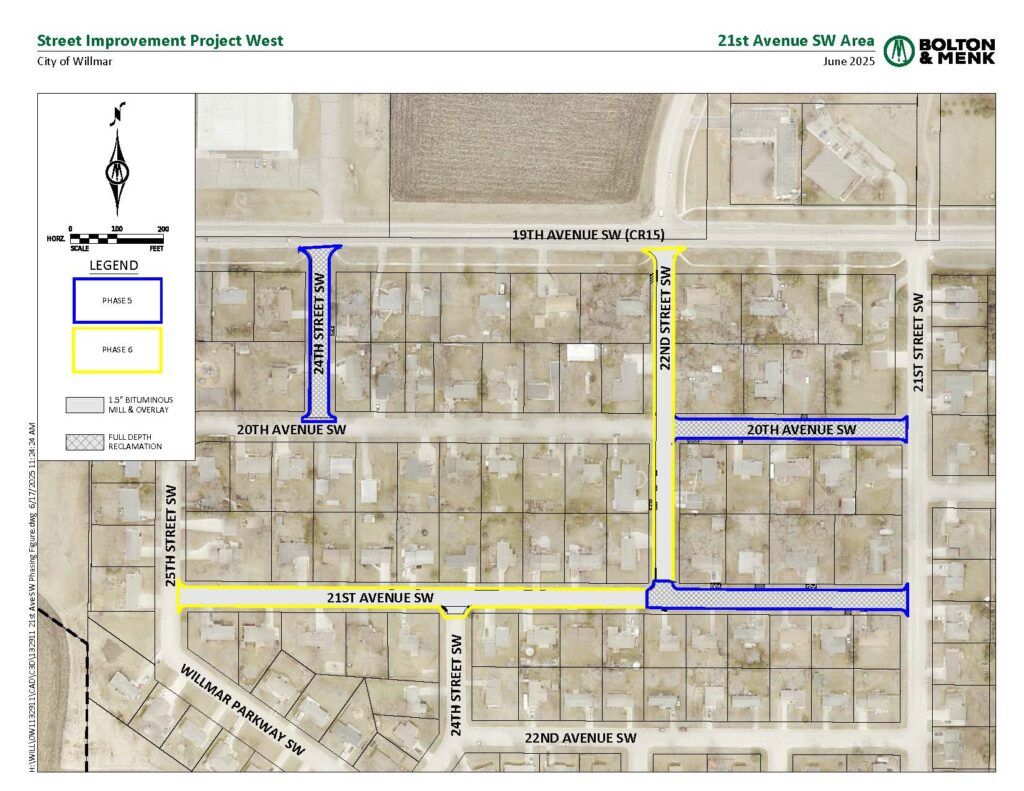

Phase 5 – 24th Street SW 20th & 21st Avenue SW (Full Depth Reclamation)
Week of May 11
- Concrete warranty (7 day curing period)
- Paving final lift of bituminous pavement (May 14 or 15)
- Seeding warranty
- Punchlist Items
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items
Phase 6 – 21st Avenue SW & 22nd Street SW (Mill & Overlay)
Week of May 11
- Concrete warranty (7 day curing period)
- Mill bituminous pavement (May 12)
- Bituminous patching (May 13)
- Paving final lift of bituminous pavement (May 14 or 15)
- Seeding warranty
- Punchlist Items
Week of May 18
- Punchlist items
Week of May 25
- Punchlist items
Additional Notes
Street Parking
Please refrain from street parking within the phase 3, 5, and 6 project areas if possible during the week of May 11. Street parking will not be allowed on phase 3, 5, and 6 Tuesday May 12, Thursday May 14, & Friday May 15 for milling and paving operations.
Sump Pump Drainlines
During paving operations, keeping water out of the roadway is extremely important. To help keep the roadway dry please remove all sump pump drainlines from the curb & gutter and have them drain into the lawn. Please try and keep the water from entering the roadway if possible. You may also turn your sump pump to the sanitary sewer for the week of May 11 if you have the option.
Turf Establishment Care
To give your grass the best opportunity to flourish please consider the following
- Water the grass seed two times daily for 10-15 minutes
- Do not rake the hydromulch up. It contains seed and fertilizer. The hydromulch will naturally decompose.
- Do not add any chemicals/fertilizers to the newly seeded area. We have already added fertilizer and pre-emergent weed killer. Adding more can potentially burn the new grass seed.
- Avoid foot traffic on newly seeded areas.
- Begin mowing on the highest setting once the grass reaches a length of 6” – 8” and slowly lower the mower deck to the desired height over the course of 4 – 5 mows.
- Weeds may appear right away while the grass is getting established, but once mowing has begun the grass should take over and the weeds die off.
New Concrete Notice
Please avoid driving on newly poured concrete curbs and driveways for at least 7 days to allow proper curing and strength development.
We appreciate your patience and understanding as we work to improve your streets.
Engineer Contacts
Nate Thein
On-site Construction Representative, Bolton & Menk, Inc.
(320)-979-9070
[email protected]
Spencer Johnson
Project Manager, Bolton & Menk, Inc.
(320)-979-6136
[email protected]
Contractor Contact
Crystal Swanson
Project Manager, Duininck Inc.
(320)-212-9384
[email protected]
