2025 190th Street Reconstruction
Project Newsletter – June 2025
190th Street between CR 9 and Beaumont Avenue will be closed to thru traffic starting June 4th. Read the latest updates to traffic closures and construction in the July Construction Newsletter.

Upcoming traffic control change at CR 9 and 190th Street for MnDOT’s CR 9 Roundabout Construction: Starting the week of July 21, MnDOT intends to implement a traffic control change at the CR 9 and 190th Street/Valley View Drive Intersection. Traffic will be switched over to the east side of CR 9 at the 190th Street / Valley View Drive intersection for construction of the west half of the roundabout that is part of the Highway 169 / TH 282 / CR 9 Interchange project. CR 9 through traffic will be maintained with one lane in each direction via the newly constructed eastern half of the roundabout. With this traffic control change, 190th Street will be closed at CR 9 for all motorists. All traffic, including local traffic with direct access off of 190th Street, will need to follow the detour along 185th Street and Beaumont Avenue as depicted on the detour map. This closure is expected to be in place through October 2025.

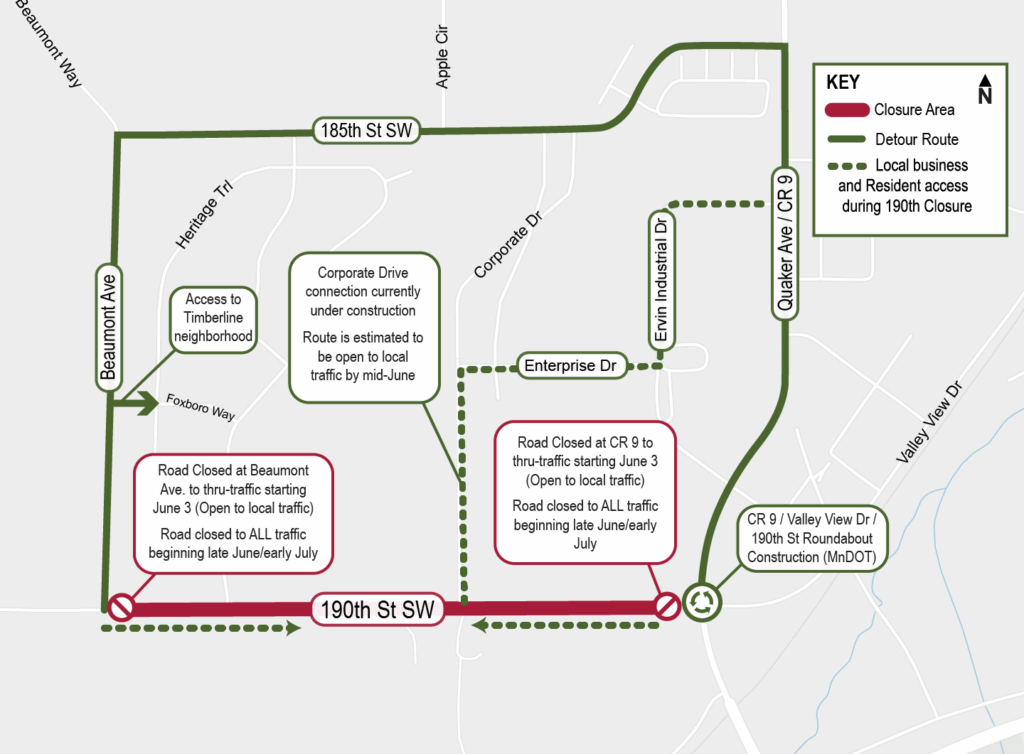

Construction Access Map
Click image to view larger version.
Project area map
Click image to view larger version.
Final design layout
Click image to view larger version.
Project background
These improvements will replace the deteriorating pavement and prepare the corridor for future growth and development in the area. Key improvements include:
- Addition of center left-turn lane and right-turn lanes
- Addition of concrete curb and gutter and storm sewer
- Improved stormwater management
- Preparing the south side of the roadway for a future multi-use trail
This construction will align with the Hwy 169 / Hwy 282 / Co. Rd. 9 interchange construction which includes a roundabout at the Co. Rd. 9 / 190th St. / Valley View Dr. intersection. More information about that project can be found on the project website.
Documents
- Project Newsletter 03 (July 2025)
- Project Newsletter 02 (June 2025)
- Project Newsletter 01 (May 2025)
- Public Meeting Presentation Video (March 2025)
- Project overview video (Feb. 2025)
- Approved roadway design layout (Sept. 2024)
- Preliminary roadway design layout (July 2024)
- Proposed typical section (March 2024)
- Open house invite (March 2024)
- Project overview video (March 2024)
Project milestones
- February 2025: Bidding
- March 5th, 2025: Public Info Meeting
- March 10th, 2025: Public Hearing on Assessments
- Late March 2025: Tree Removals
- Spring 2025: Private Utility Relocations
- Spring – Fall 2025: Construction
Contacts
Project phone hotline: 952-698-0378
Alex Madson
On-Site Construction Manager
Bolton & Menk
(952) 256-3222
Alex.Madson@bolton-menk.com
Luke Wheeler
Assistant City Engineer
Bolton & Menk
(612) 597-9105
Luke.Wheeler@bolton-menk.com
